Ipswich Museum: Behind schedule, over budget, and...worth it?

We were invited inside Ipswich Museum on Wednesday, 18 March – six days before councillors are due to vote on whether to commit a further £492,625 to complete the project that has fallen way behind schedule.

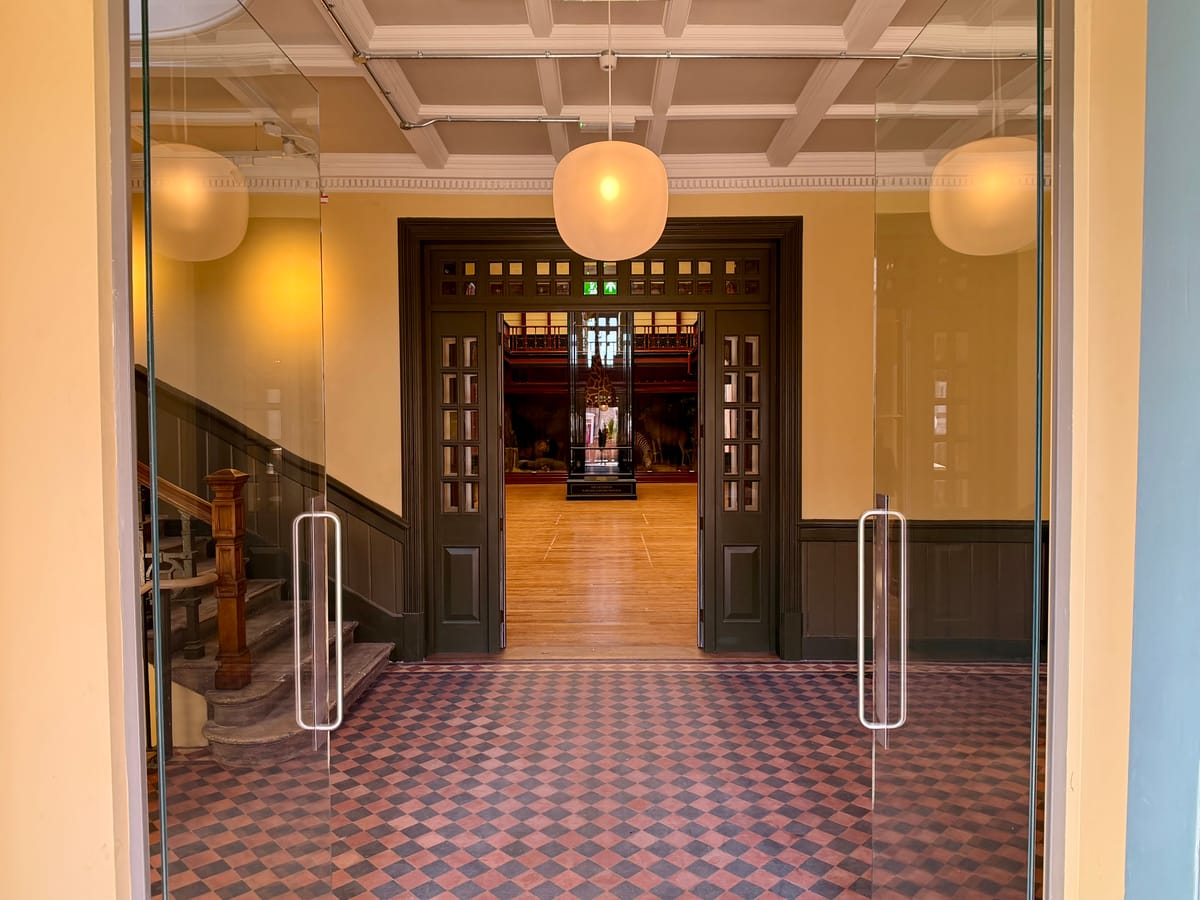

The entrance to Ipswich Museum in March 2026
The entrance to Ipswich Museum in March 2026

The timing was not coincidental, but what we saw made a persuasive case that it could yet be worth it.

It has been more than three years since Ipswich Museum closed its doors in October 2022, and progress has not always been easy to see from the outside. But standing inside the building now, the scale of what has been achieved is hard to miss.

The base build – carried out by Gipping Construction, an employee-owned firm established in 2004 with significant heritage experience – is complete. A new roof, new lift, new staircase, raised floor levels, and a reconfigured basement have transformed the fabric of the Grade II listed Victorian building. More natural light, better flow, genuine accessibility. When the fit-out is complete, this will be a noticeably different museum from the one that closed.

When we last visited, in the middle of the construction phase last April, the scale of the project was already apparent. Andy Laflin, managing director of Gipping Construction, put it memorably at the time: "If you combined all the internal and external scaffolding, it would reach from here to Felixstowe." Every individual roof tile was carefully removed, cleaned and refitted – removing the old mortar alone filled four large skips.

Few projects, he might have added, also require workers to manoeuvre around a full-size woolly mammoth and a whale skull suspended from the ceiling.

Now, with scaffolding down and the structural work done, the building is ready for the final phase: the gallery fit-out and interpretation works that will bring Ipswich's collections back to life. A new café, improved shop, and a more accessible outdoor space will add to a visitor experience that should be considerably more welcoming, accessible and enjoyable than what came before.

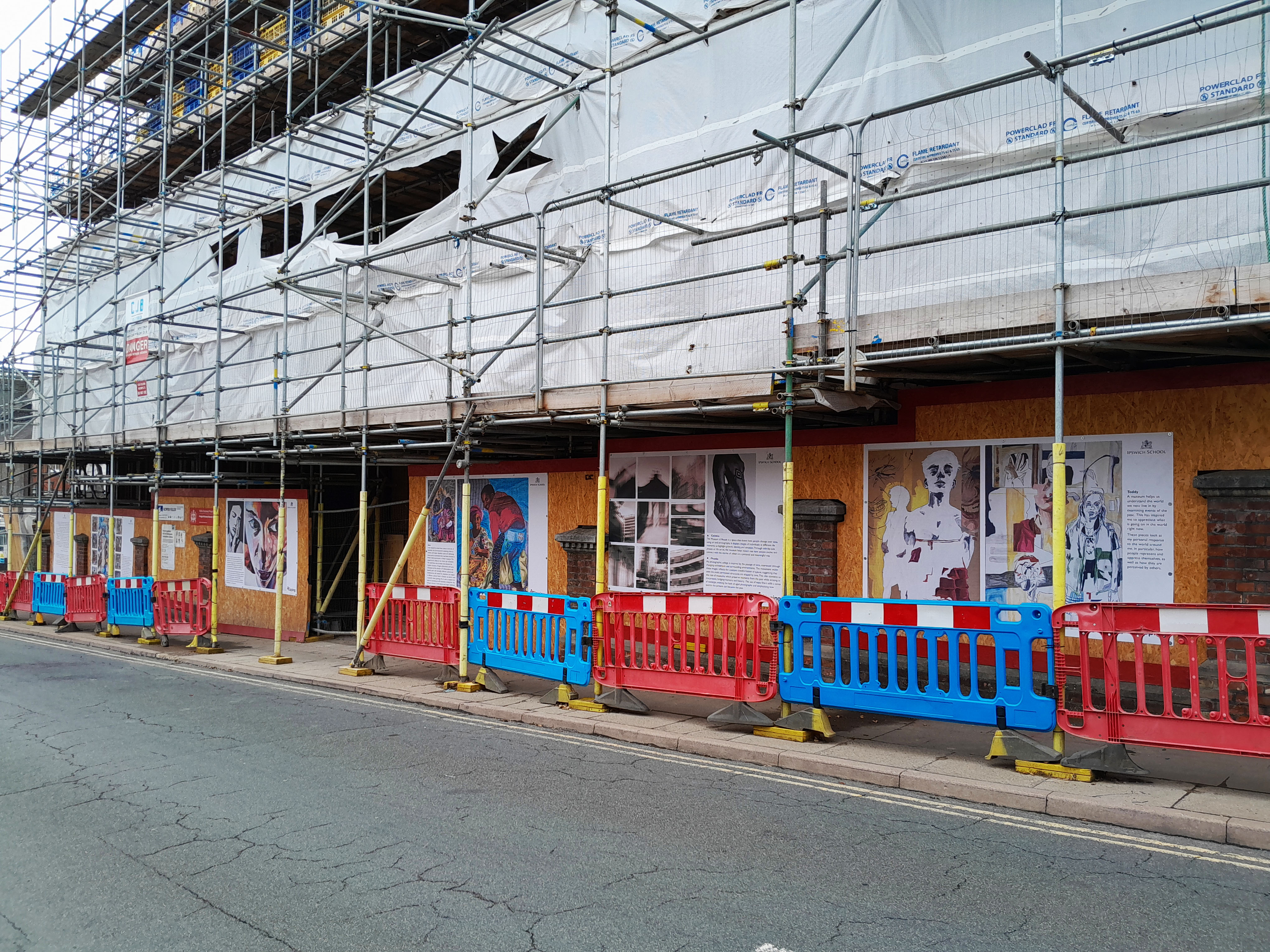

Ipswich Museum streetscape
Ipswich Museum streetscape (Gipping Construction)

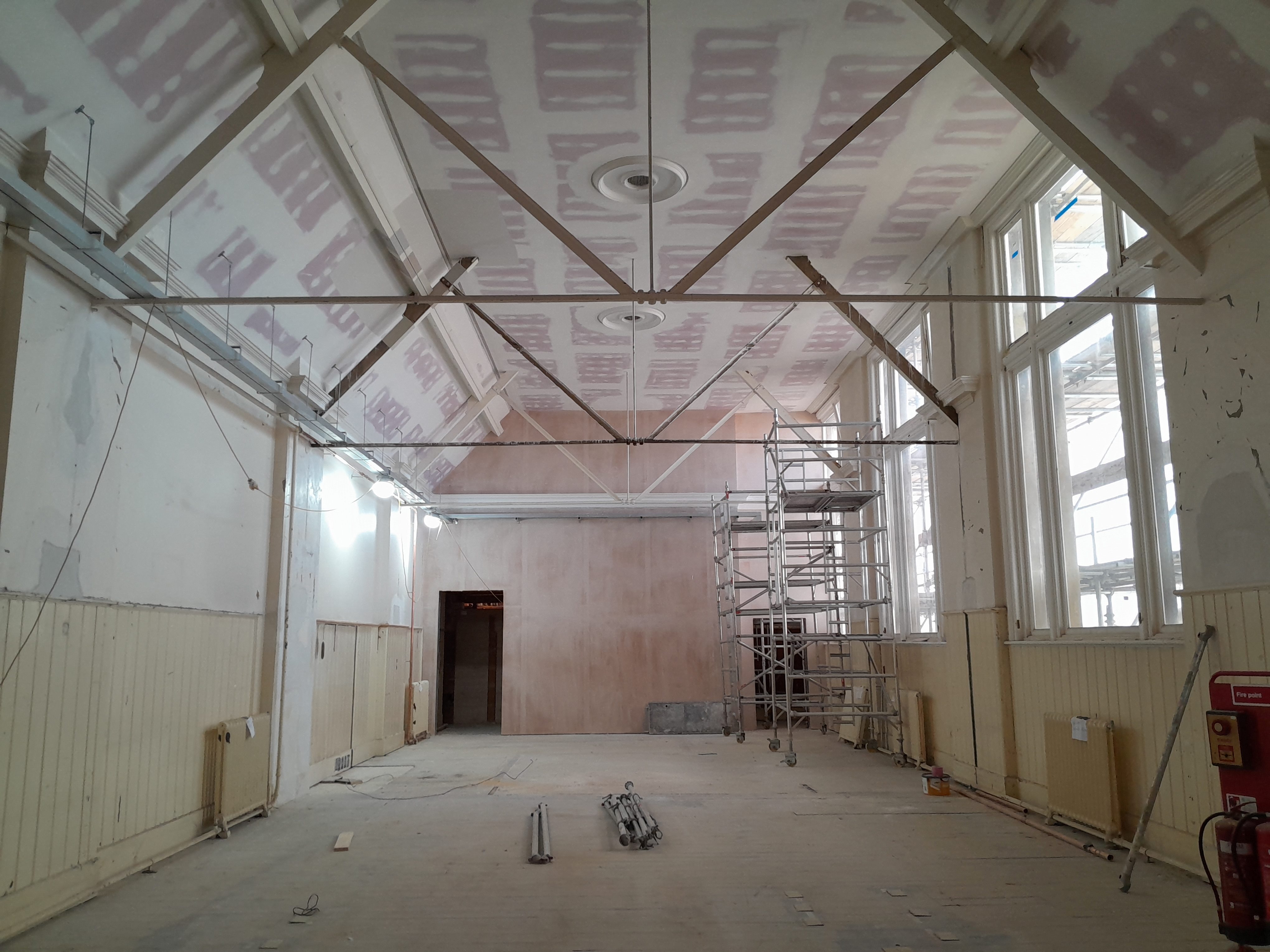

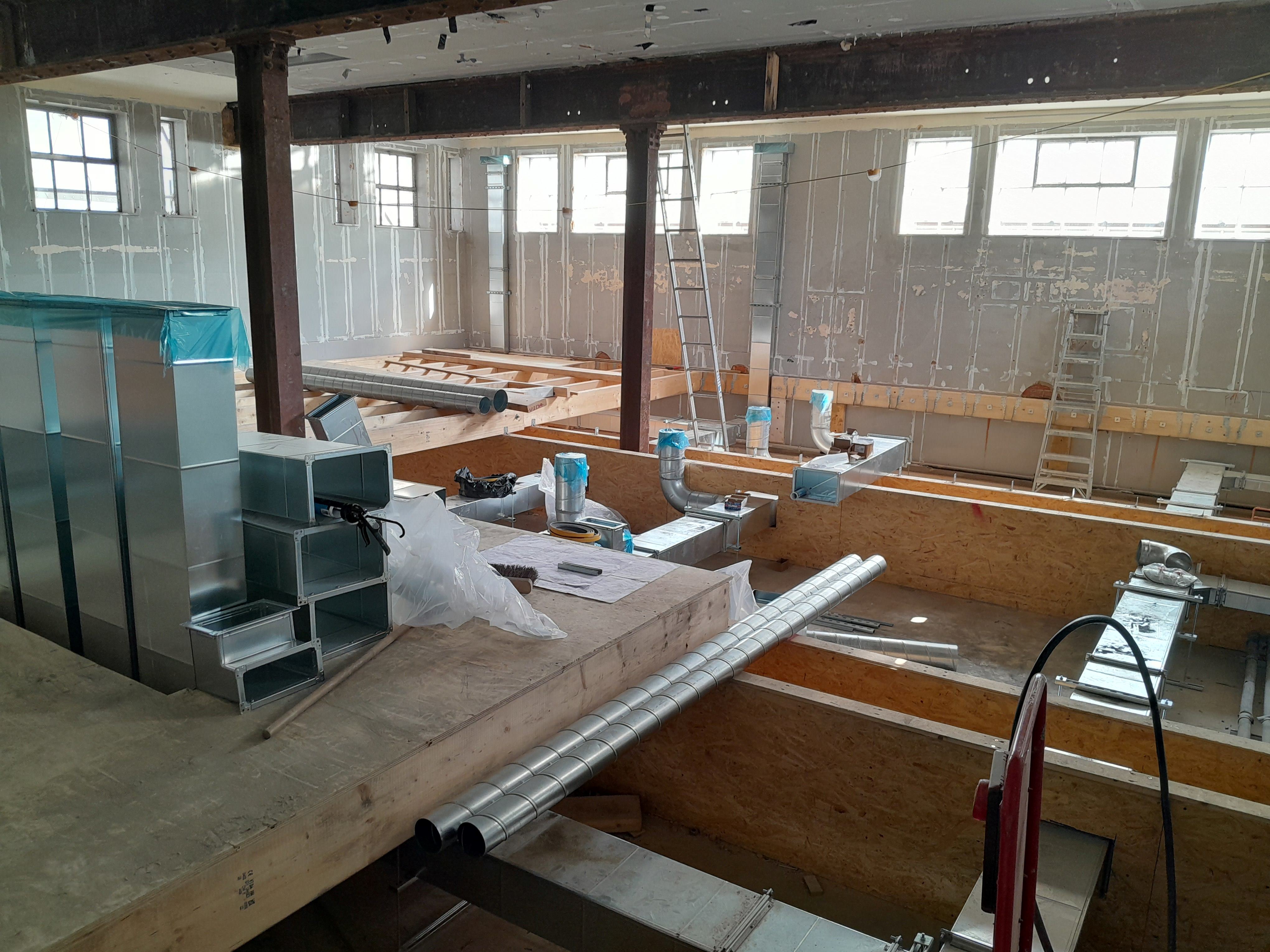

Work in progress at Ipswich Museum
Work in progress at Ipswich Museum (Ipswich Borough Council)
Work in progress at Ipswich Museum
Work in progress at Ipswich Museum (Ipswich Borough Council)

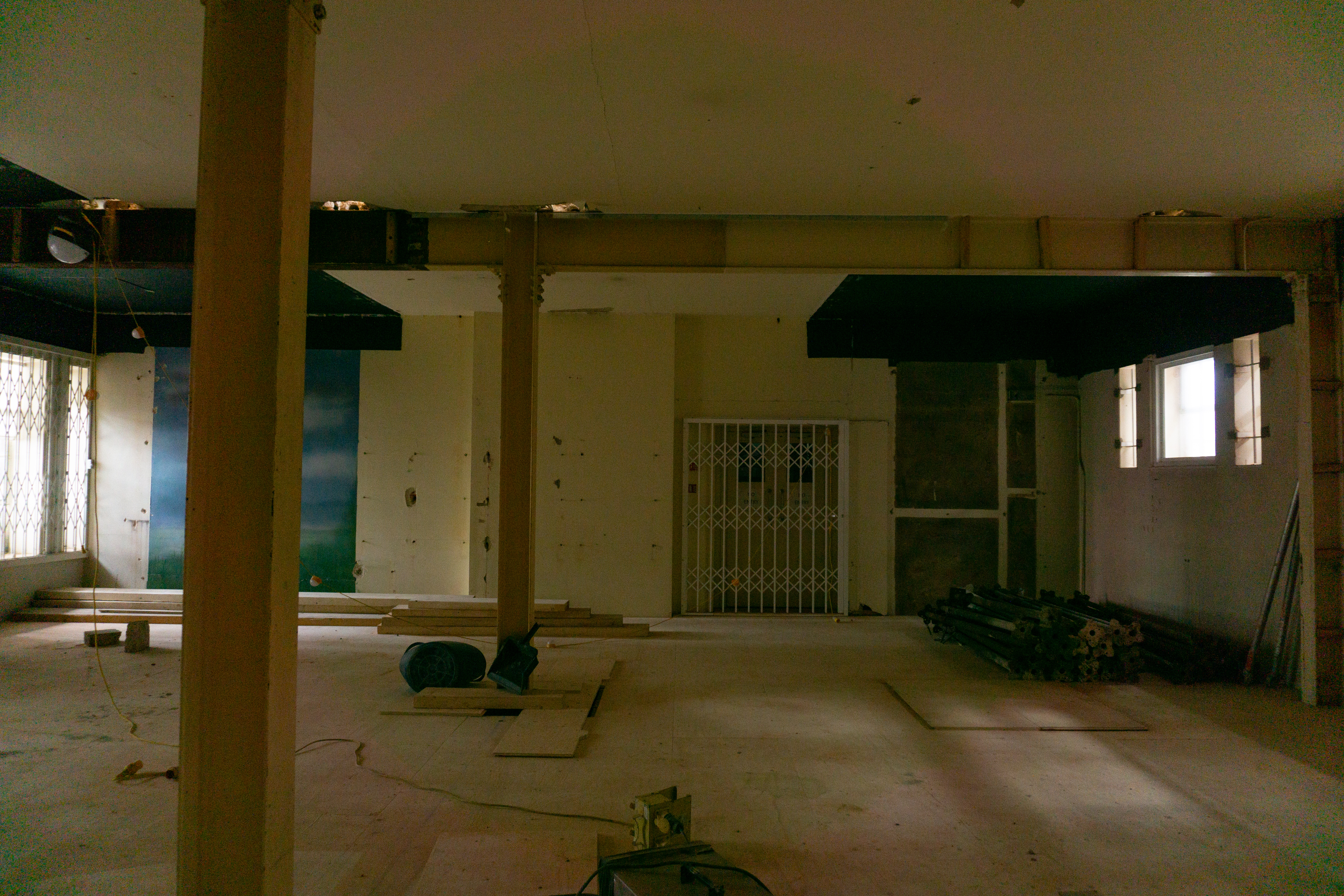

Gipping Construction doing on going renovations to inside of Ipswich Museum
On going renovations at the Ipswich Museum Photo: Sophie Debenham (Ipswich.co.uk)

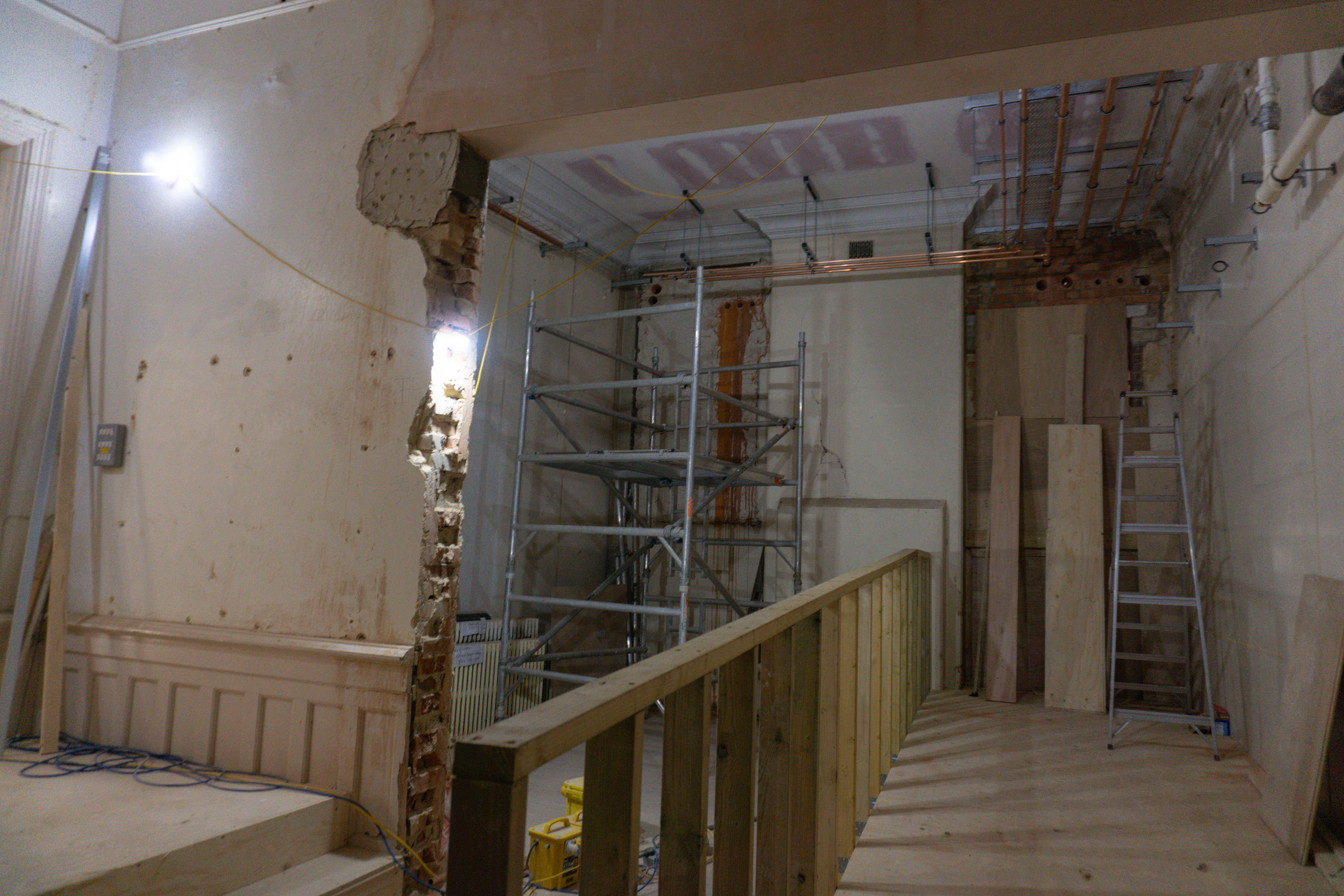

Progress of the interior renovations, including new raised floors for accessibility improvements, new cornice that matches the original and a lot of new plumbing
Progress of the interior renovations, including new raised floors for accessibility improvements, new cornice that matches the original and a lot of new plumbing Photo: Sophie Debenham (Ipswich.co.uk)

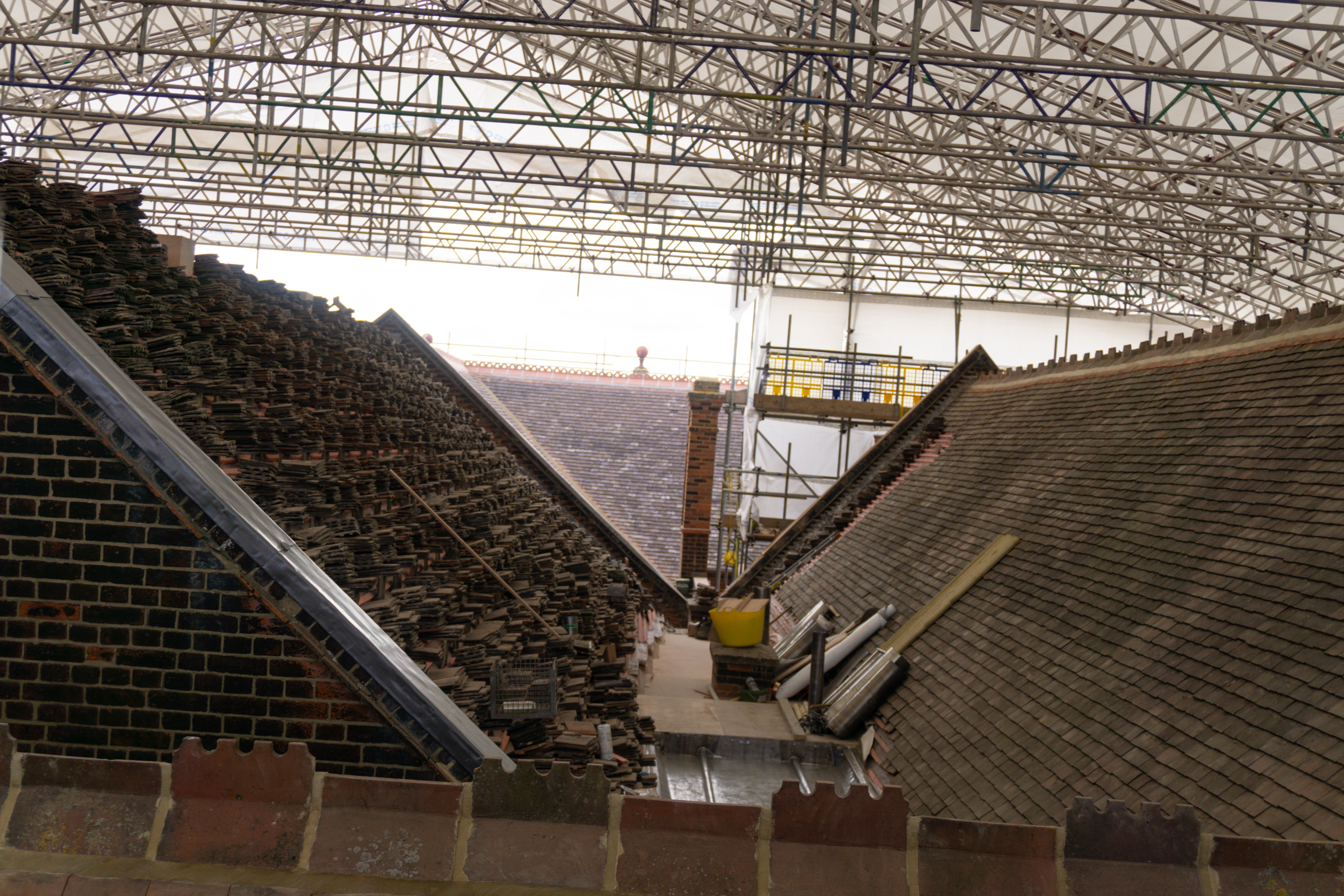

Renovation of the museum roof was a humongous undertaking
Renovation of the museum roof was a humongous undertaking Photo: Sophie Debenham (Ipswich.co.uk)

The difficult conversation

None of that, however, changes the uncomfortable reality that this project is significantly behind schedule and over budget – and that the council now needs more money to finish it.

Ipswich Museum was originally scheduled to reopen in 2025. That was pushed back to the end of 2026. It has now been pushed back again, to the first quarter of 2027. There is almost an expectation that more delays will follow.

The original budget was £8.7m. The project's total cost, if the additional funding requested is approved at the council's executive meeting on Monday, 24 March, will be £12,359,043. Ambitious projects will always require some wiggle room, but £3,659,043 is...well...an awful lot of wiggling.

The extra £492,625 is attributed to what the council describes as "additional unexpected costs, ongoing high price levels and inflation." Councillors are being asked to commit £246,312.50 directly from council funds, while underwriting a further £246,312.50 pending an application to the National Lottery Heritage Fund (NLHF), which has already contributed £5,687,297 to the project.

Cllr Carole Jones, the authority's lead for museums, acknowledged the challenges plainly. "This has been a huge project with unexpected challenges which have taken more time, and funding, than we had hoped," she said. "However, this extra push to ensure we get it finished and over the line is so important."

It is a fair point — but it is also one the council has had to make more than once. For an authority facing local elections in May, with voters already scrutinising its ability to deliver large-scale projects, the optics of another delay and another funding request are not easy to manage. The press visit this week did nothing to dispel the impression that the council is perhaps seeking to build public goodwill ahead of time.

Why the delays are not wholly surprising

For those inclined to give the project the benefit of the doubt, there is a reasonable argument to be made that cost overruns of this kind are not unusual in complex heritage restoration.

"It is literally impossible to know every detail of a project of this scale until you start peeling back the layers," a project manager explained during an earlier visit, highlighting how hidden issues inevitably emerge once work begins on historic buildings. The Ipswich Museum building dates from the 1880s and has seen few major structural interventions since; the surprises it yielded were, in that context, predictable if not foreseeable.

What is also worth noting is that the project has not been funded primarily from council reserves. The broader funding picture includes contributions from the NLHF, the Wolfson Foundation, the Foyle Foundation, and the Friends of Ipswich Museums, among others. External fundraising, initially budgeted at £490,000, has exceeded its target by £436,000 — a genuine achievement that tends to be overlooked in the conversation about overruns.

What Ipswich stands to gain

There is a cultural argument here that deserves to be made alongside the financial one.

Ipswich Museum, which first opened in 1881, is one of the town's most significant heritage assets. Its collections span natural history, geology, ancient Egypt, Roman Suffolk, and the story of the town and its people. For a town that has sometimes struggled to assert its cultural identity, a fully renovated, accessible, and modern museum is not a luxury — it is cultural infrastructure.

Ipswich Museum in March 2026
Ipswich Museum in March 2026 Photo: Oliver Rouane-Williams (Ipswich.co.uk)

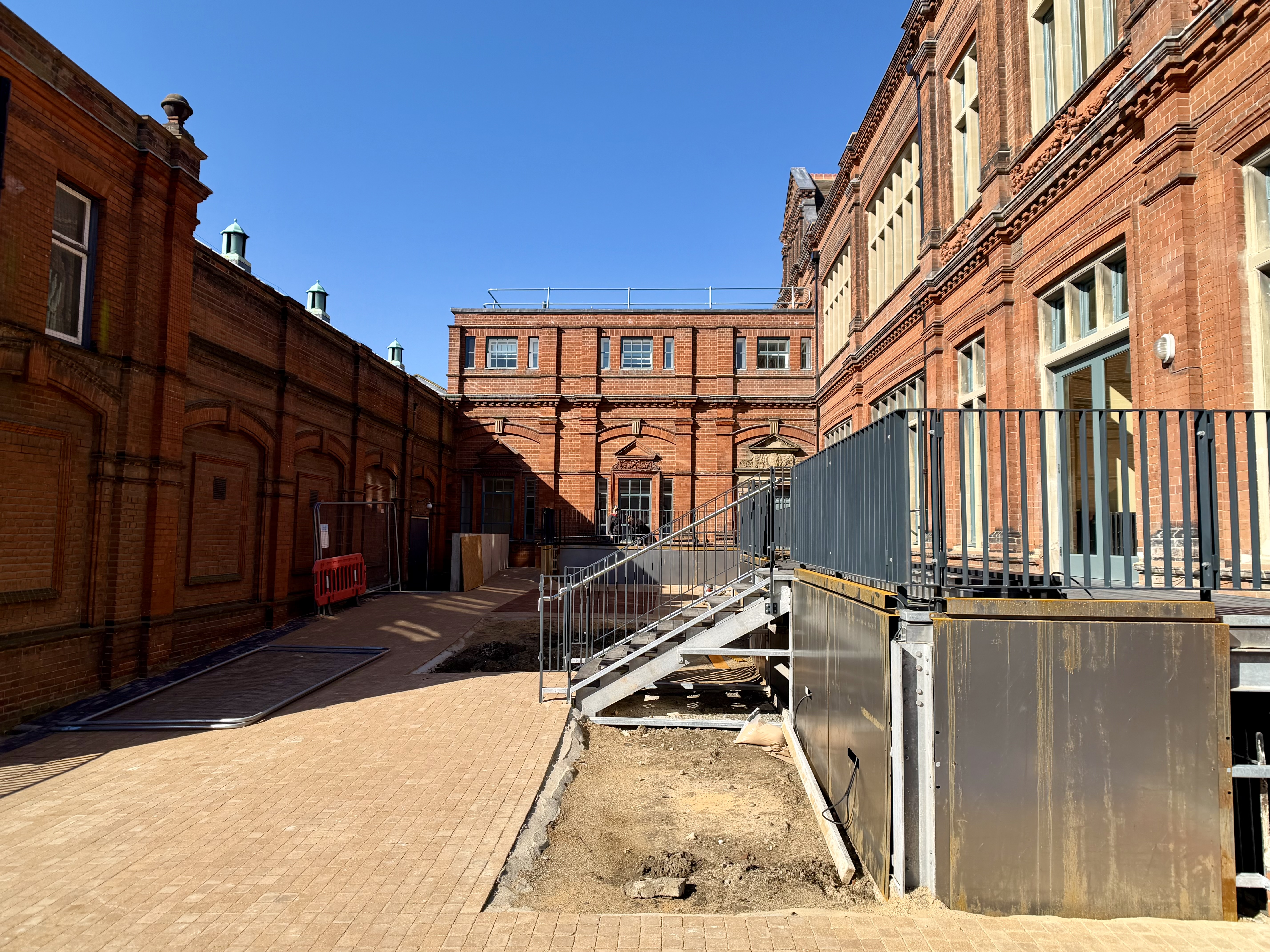

Outside Ipswich Museum in March 2026
Outside Ipswich Museum in March 2026 Photo: Oliver Rouane-Williams (Ipswich.co.uk)

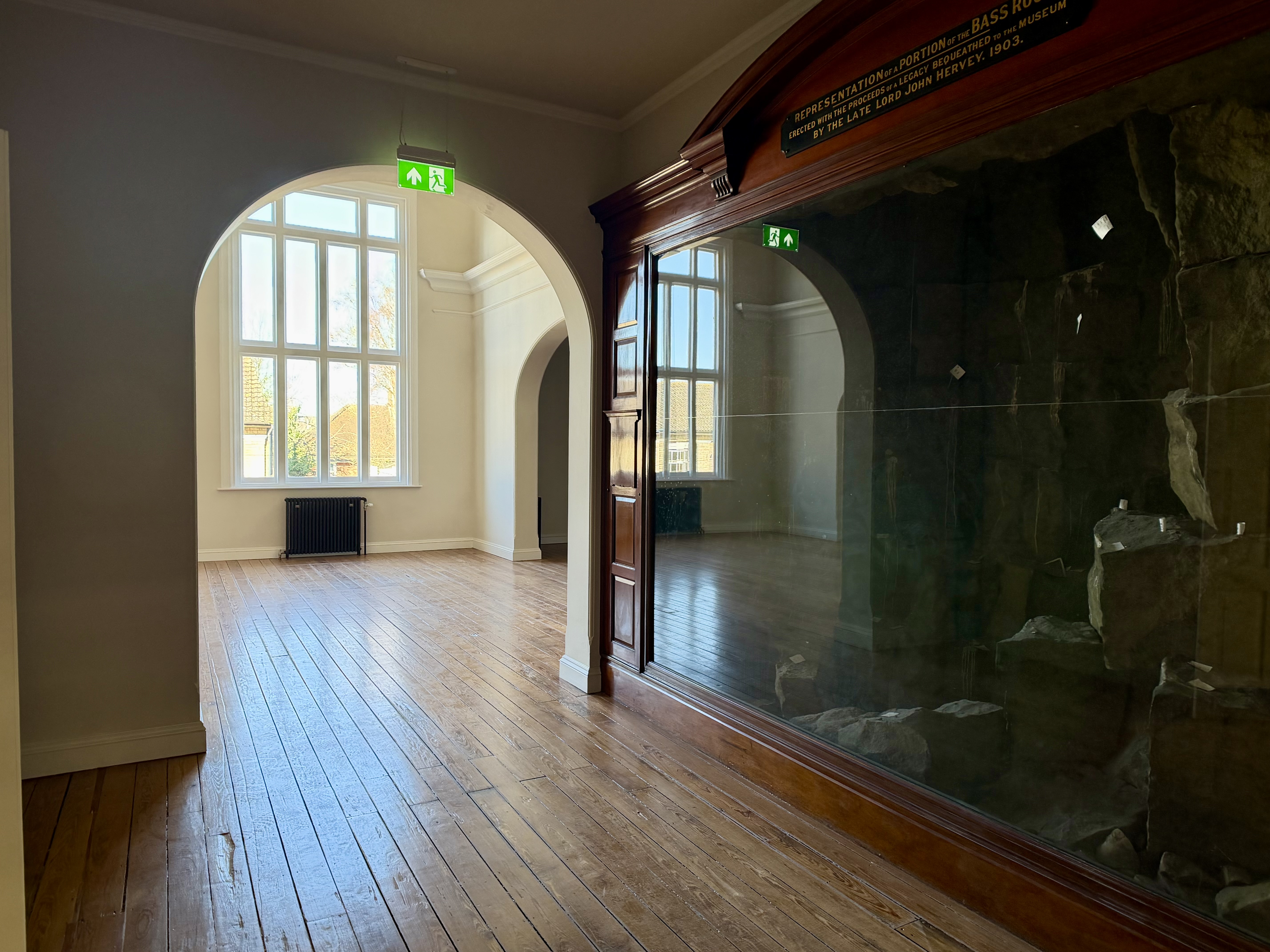

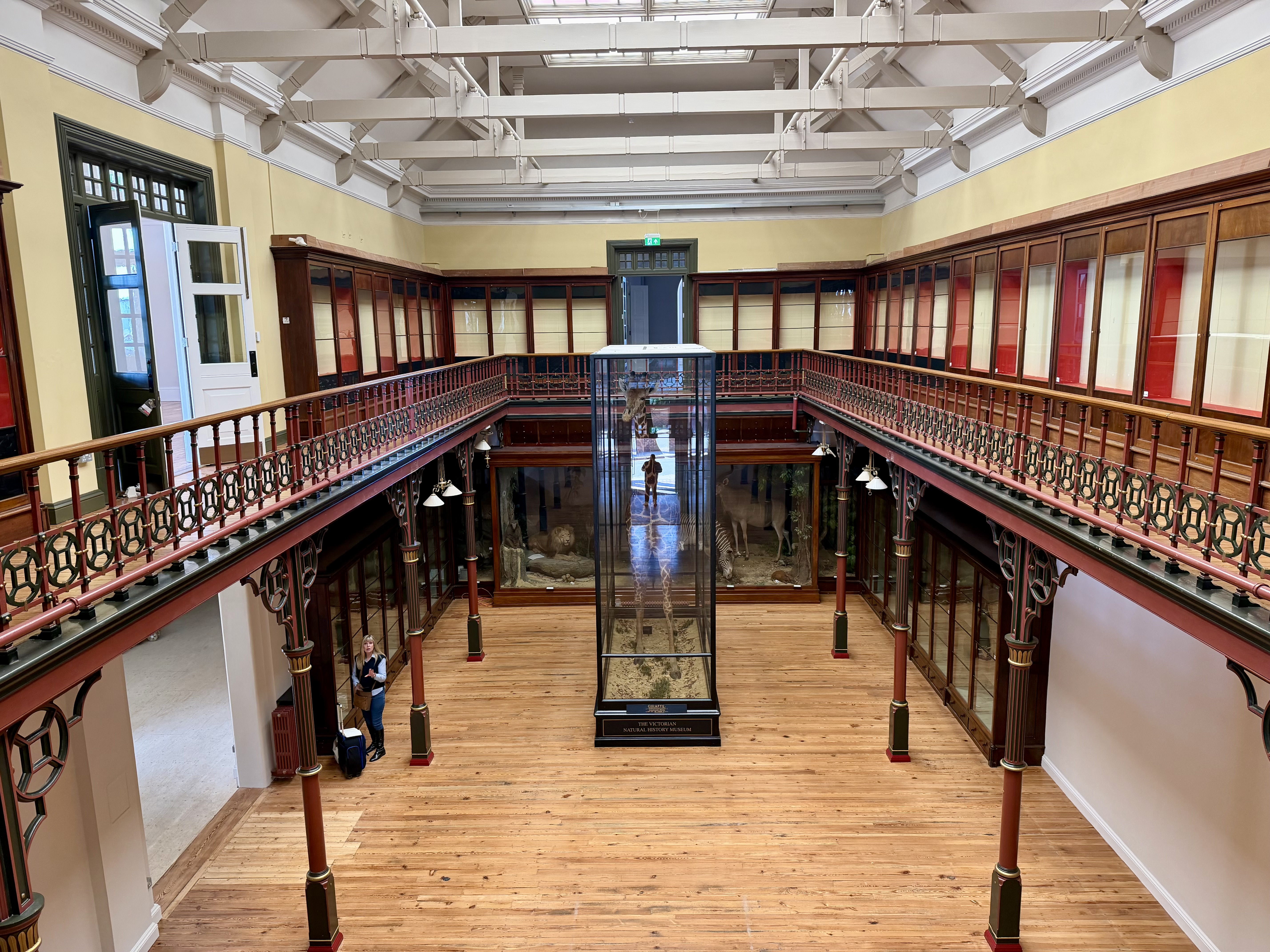

Inside Ipswich Museum in March 2026
Inside Ipswich Museum in March 2026 Photo: Oliver Rouane-Williams (Ipswich.co.uk)

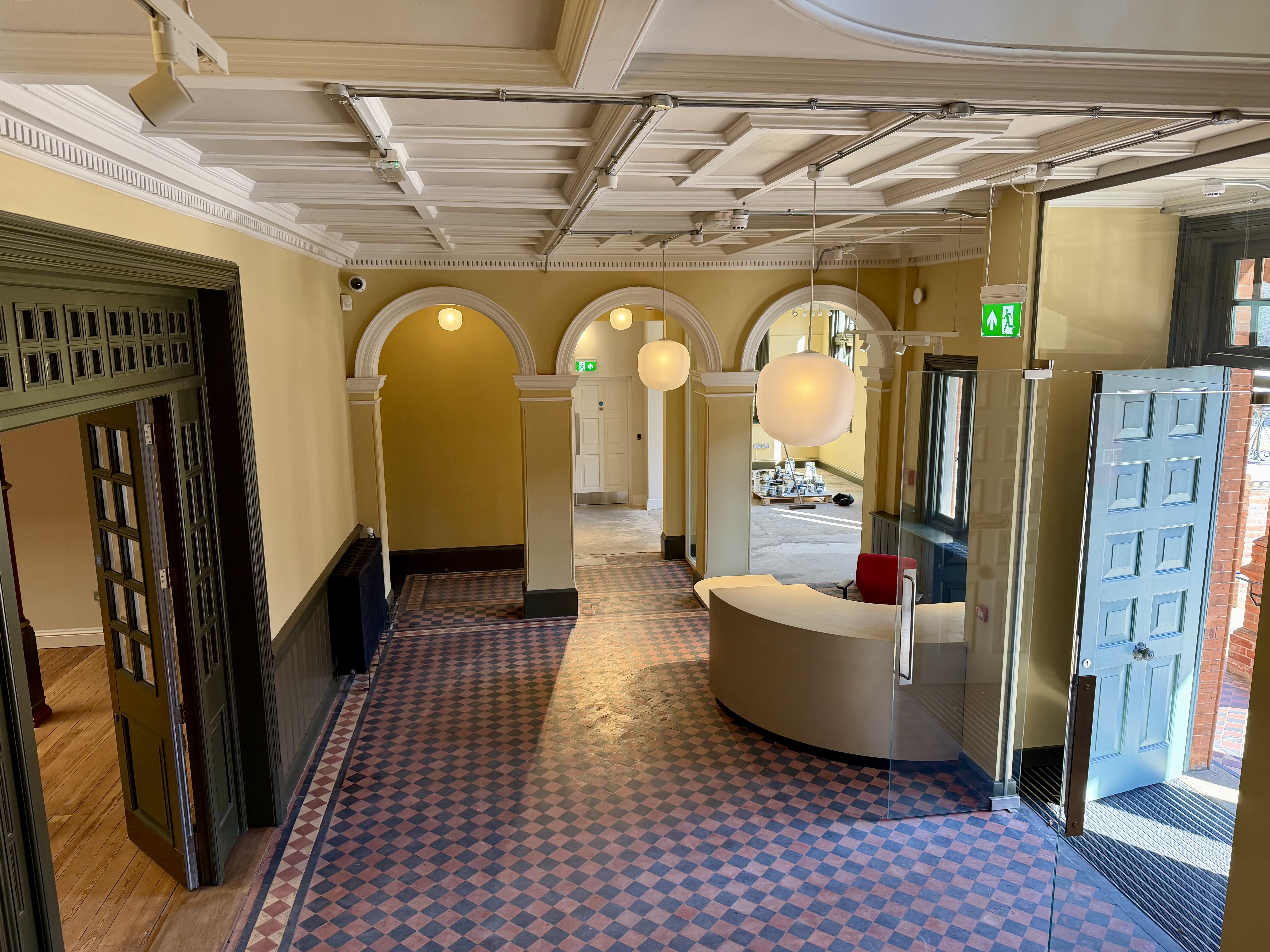

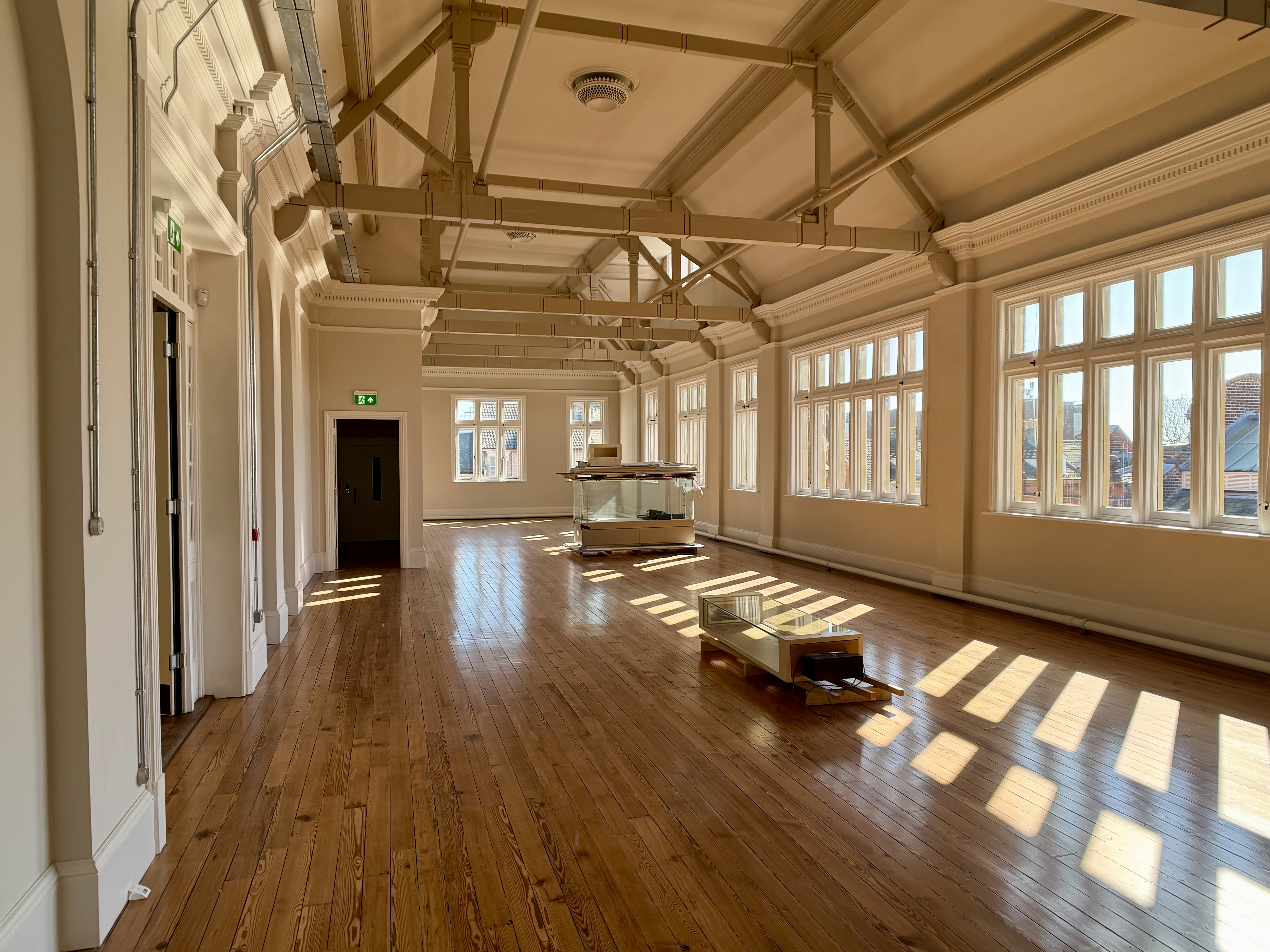

Inside Ipswich Museum in March 2026
Inside Ipswich Museum in March 2026 Photo: Oliver Rouane-Williams (Ipswich.co.uk)

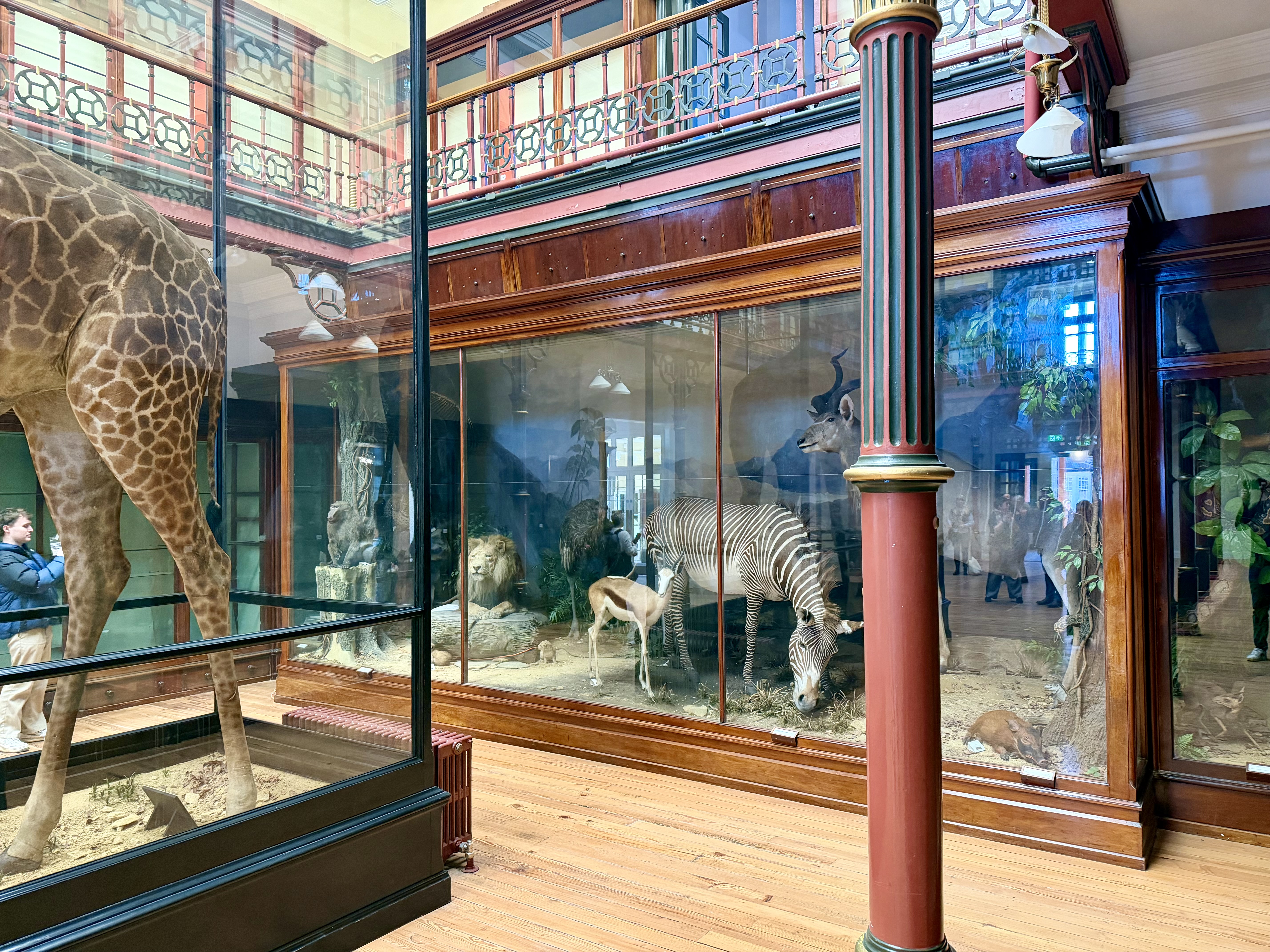

Inside Ipswich Museum in March 2026
Inside Ipswich Museum in March 2026 Photo: Oliver Rouane-Williams (Ipswich.co.uk)
Inside Ipswich Museum in March 2026
Inside Ipswich Museum in March 2026 Photo: Oliver Rouane-Williams (Ipswich.co.uk)
Inside Ipswich Museum in March 2026
Inside Ipswich Museum in March 2026 Photo: Oliver Rouane-Williams (Ipswich.co.uk)

"The museum has undergone a remarkable transformation so far, and we look forward to sharing this with Ipswich people and visitors once this hard work is completed," said Cllr Jones.

From what we saw on Wednesday, the finished building will be worth the wait. That does not make the delays or the additional cost any less frustrating, but it does mean that the case for seeing the project through is a strong one.

The bottom line

Ipswich Museum has been closed for more than three years, has cost millions more than originally planned, and will not reopen until early 2027 at the earliest. The council's decision to invite the press inside days before a public funding decision was a transparent piece of expectation management — but the building itself made a more honest argument. The question is not really whether to finish the job. It is whether the council can do so with the credibility it needs to convince a sceptical public that the end result is worth every penny. On current evidence, it probably is.
